- A typical kitchen remodel timeline in Chester County, PA runs 6-14 weeks depending on scope.
- Custom cabinet lead time (6-10 weeks) is usually the single biggest driver of your overall schedule.
- Layout or plumbing/electrical changes require township permits, which typically add 1-3 weeks.
- Finalizing selections before demo day is the most effective way to keep your project on schedule.
If you’re mapping out your kitchen remodel timeline in Chester County, PA, the honest answer is “it depends” — but not in a vague way. The scope of your project, your cabinet selection, and whether you’re moving plumbing or electrical all combine into a predictable schedule once you know what drives it. At Smarter Improvements, we’ve walked dozens of Chester and Delaware County homeowners through this exact planning process. This guide breaks down realistic timeframes by project type, a week-by-week look at what actually happens, and the choices that add — or save — weeks on your schedule.

What Affects How Long Your Kitchen Renovation Takes
Before we get to specific week counts, it helps to know what actually moves the needle on a kitchen project’s schedule:
- Cabinet lead time — Semi-custom and custom cabinets take 6-10 weeks to manufacture after you place the order. This clock starts the day you finalize your selection, not the day demo begins.
- Layout changes — Keeping your sink, stove, and refrigerator in their current locations avoids plumbing and electrical relocation, which saves both time and permit complexity.
- Permits — Chester County townships require permits for plumbing, electrical, and structural changes. Turnaround typically runs 1-3 weeks depending on your municipality.
- Countertop material — Quartz and granite require templating after cabinets are installed, then 1-2 weeks of fabrication before they’re ready to install.
- Decision-making speed — Projects slow down the most when homeowners haven’t finalized finishes (tile, hardware, paint color) before their contractor needs them.
Kitchen Remodel Timeline by Project Scope in Chester County, PA
Here’s how the three most common kitchen project types break down, based on projects we’ve completed across Exton, West Chester, Downingtown, and Malvern:
| Project Type | Typical Timeline | What’s Included |
|---|---|---|
| Cosmetic Refresh | 1-3 weeks | Cabinet refacing or repaint, new hardware, backsplash swap, same layout and countertops |
| Mid-Range Remodel | 6-9 weeks | New cabinets in the same footprint, new countertops, flooring, and lighting; no plumbing or electrical moves |
| Full Gut Renovation | 10-14+ weeks | Layout changes, relocated plumbing/electrical, permits, structural work, and full finish selections |
Note: these ranges start from the day demo begins. Add 2-4 weeks up front for design, selections, and ordering cabinets before your contractor ever picks up a hammer.
Week-by-Week: What to Expect During Your Kitchen Renovation
For a typical mid-range to full kitchen remodel, here’s the sequence we walk Chester County homeowners through:
- Design & selections (2-4 weeks before demo) — Finalize cabinet style and finish, countertop material, backsplash, and layout. Cabinets are ordered immediately once selections are locked in — this starts the 6-10 week manufacturing clock.
- Permit approval (1-3 weeks, if needed) — Required for plumbing, electrical, or layout changes. Runs concurrently with cabinet lead time in most cases, so it rarely adds to the overall schedule.
- Demolition (1-2 days) — Old cabinets, countertops, and flooring (if being replaced) are removed.
- Rough-in work (3-5 days) — Electrical and plumbing relocations, if any, happen before walls close back up.
- Rough-in inspection — Required before drywall repair if any plumbing or electrical was moved.
- Drywall, paint, and flooring (1-2 weeks) — Walls are patched and painted, new flooring is installed.

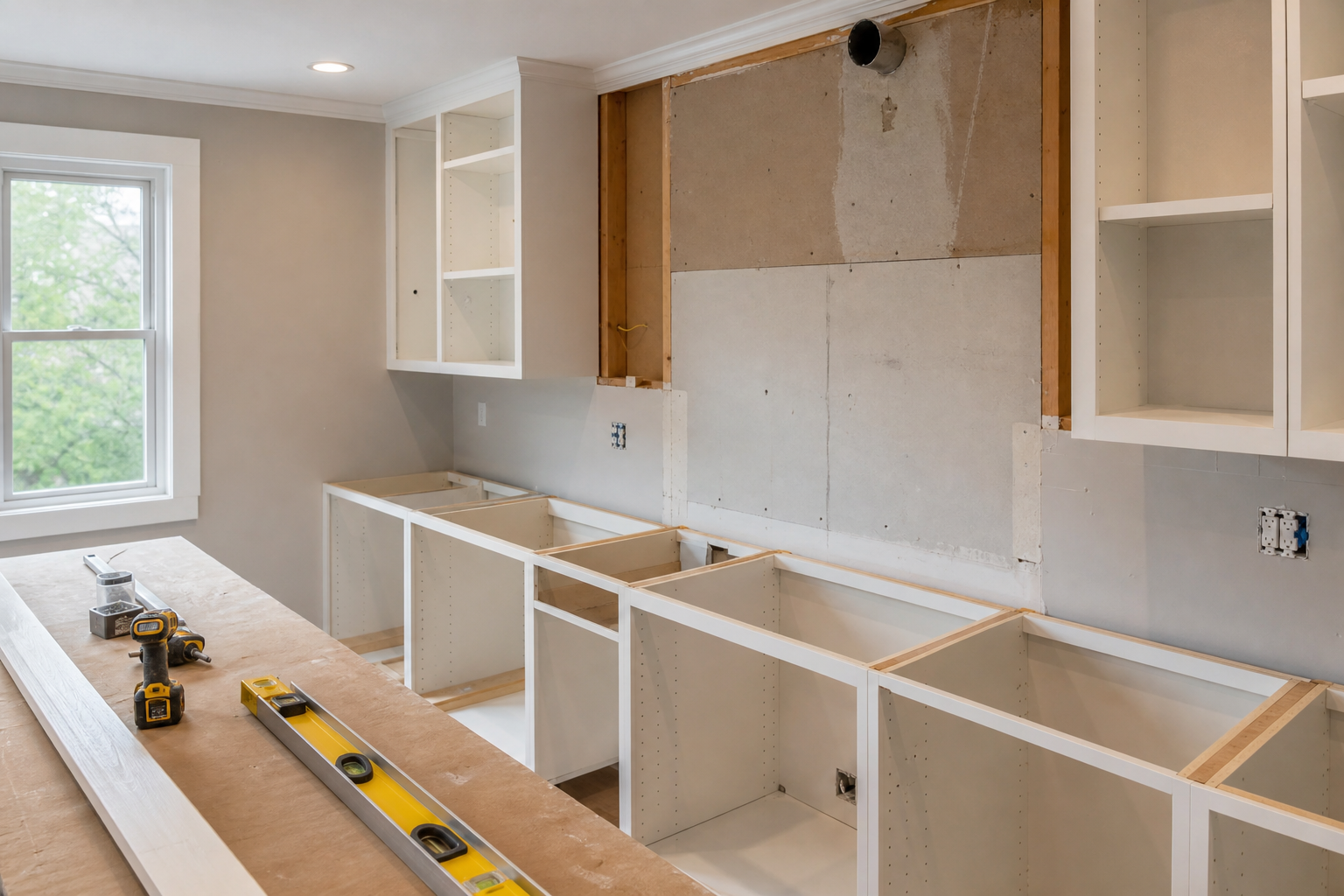

- Cabinet installation (3-5 days) — This step waits on cabinet delivery, which is typically the schedule’s longest lead time.
- Countertop templating and fabrication (1-2 weeks) — Templating happens within a day or two of cabinet install; fabrication takes 1-2 weeks before the countertop is ready.
- Countertop and backsplash install (3-4 days) — Countertops are set, then backsplash tile is installed and grouted.
- Appliances, fixtures, and trim-out (2-3 days) — Appliances are connected, plumbing and electrical fixtures installed, and trim work completed.
- Final walkthrough and punch list (1-2 days) — We address any final details and confirm everything is complete before handoff.

How to Avoid Delays and Keep Your Kitchen Remodel on Schedule
Most kitchen remodel delays we see in Chester County trace back to a handful of avoidable causes:
- Lock in cabinet selections early — Since cabinet lead time is usually the longest single item on the schedule, ordering late is the most common cause of a delayed project. Compare cabinet refacing versus full replacement before demo day, not during it.
- Choose in-stock or quick-ship lines when timeline matters — Some cabinet manufacturers offer 2-3 week turnaround on standard sizes and finishes, which can shave over a month off a full custom order.
- Finalize every finish before demo starts — Backsplash tile, hardware, paint color, and lighting fixtures should all be selected and in hand (or on order) before your contractor needs them.
- Confirm appliance lead times — Specialty or made-to-order appliances can take several weeks to arrive. Order them as soon as your layout is finalized.
- Plan for a temporary kitchen — A microwave, mini fridge, and hot plate in a nearby room keeps daily life manageable during the 4-8 weeks your kitchen is out of commission.

Why Chester County Homeowners Trust Smarter Improvements
Smarter Improvements is a fully licensed and insured general contractor with over 10 years of experience renovating homes across Chester and Delaware County. Whether it’s a kitchen renovation, a bathroom remodel, or a window and door project, we give homeowners a written, itemized timeline before work begins — not a verbal estimate — so you know exactly what to expect each week.
We’ve completed dozens of kitchen projects across Exton, West Chester, Downingtown, and Malvern, and we manage permits, inspections, and scheduling directly with your township so you don’t have to. Read what local homeowners say about working with us, or browse recent projects on our portfolio page.
Frequently Asked Questions About Kitchen Remodel Timelines in Chester County PA
How long does a kitchen remodel take in Chester County PA?
Most Chester County PA kitchen remodels take 6-14 weeks from demo to move-back-in, depending on scope. A cosmetic refresh can wrap in 1-3 weeks, a mid-range remodel with new cabinets and countertops typically runs 6-9 weeks, and a full gut renovation with a layout change runs 10-14+ weeks.
What is the biggest cause of kitchen remodel delays in Chester County?
Cabinet lead time is the single biggest factor. Semi-custom and custom cabinets typically take 6-10 weeks to manufacture after you place the order, so late cabinet selections push the entire project back regardless of how fast the on-site labor moves.
Do I need a permit for a kitchen remodel in Chester County PA?
A permit is required if you’re moving plumbing or electrical, changing the layout, or altering structural walls. A like-for-like cabinet, countertop, and finish swap with no layout changes usually does not require a permit, but your contractor should confirm with your township.
Can I speed up my kitchen remodel timeline?
Yes. Finalize your cabinet style, countertop material, and fixture selections before demo begins so cabinets can be ordered on day one. Choosing in-stock or quick-ship cabinet lines instead of full-custom can also cut several weeks off the schedule.
How long will I be without a kitchen during renovation?
For a mid-range or full remodel, expect 4-8 weeks without a functioning kitchen once demo starts. Many Chester County homeowners set up a temporary kitchen station with a microwave, mini fridge, and hot plate in a nearby room during this stretch.
